Roads in Niwot — Facts, Options, and Answers
May 8, 2026
Niwot has 31 miles of roads. 23 of them have no funded plan for repair. Every year of delay raises the cost. Three paths exist — only one solves it for the whole community.
- 31 miles of roads in the proposed town. The county now plans to repair only 5 miles of main arteries; 23 miles have no funded repair plan.
- Average PCI of 44 across the 23 unfunded miles — well below every comparable Colorado municipality.
- Three paths exist: the Town plan ($1.8M/yr, sales-tax backed), a community-wide PID ($2.3M/yr at ≥14 mills), or a patchwork of neighborhood PIDs (20–25+ mills each).
- The longer the wait, the higher the cost. Repair triples or quadruples as PCI drops below 50, then below 25.
- Sellers may have to disclose it. Colorado requires sellers to disclose known material adverse facts — and the absence of a road-repair plan for these 23 miles can qualify.
Facts to Agree Upon
- The proposed town has 31 miles of roads. Less than 3 miles are privately owned. Boulder County abandoned 20 miles of roads in 1996 and said in 2025 it is abandoning another 3 miles of “residential collector” roads, now repairing only 5 miles of main arteries. The average PCI of the 23 miles of road that no one repairs is 44, well below any responsible community standard. Costs increase dramatically over time as road conditions fall below the threshold for chip or slurry seal. Some roads are unsafe and need immediate repair.
- Full-depth reclamation (FDR) and mill & overlay (M&O) are preferred repair methods and are used by major road contractors throughout Colorado. PCI thresholds for each method will be finalized in the project engineering phase. FDR is cost-effective, environmentally preferred, reduces exposure to oil-price volatility, and greatly reduces full-depth repair time compared to traditional remove-and-replace (R&R) reconstruction.
- Although Boulder County uses both R&R and FDR as acceptable reconstruction methods, the County chooses conservative assumptions (including R&R) when setting mill levies for a PID to ensure all contingencies are covered. This results in higher initial project costs than the town model.
- The 2025 community-wide PID proposal included properties that have private or existing PID roads. It encountered objections from those property owners that would be difficult to overcome. Excluding those properties, however, raises the mill levy on the rest — making any future PID harder to pass.
- Roads are a community asset. The road in front of your house doesn’t get you anywhere on its own. Without county contribution or financing, neighborhoods would face higher mill levies and substantial work to establish individual PIDs — and a patchwork of PIDs would leave orphan residential collectors (Meadowdale Dr, Dry Creek Rd, Longview Dr, Somerset Dr) without an owner.
- HOAs cannot legally fix roads dedicated to the county. Under CCIOA, HOA assessments can only be spent on common elements; a public road is not a common element. HOAs also are not in a position to assume full liability for public roads.
- The town would use sales tax to back a road bond, better aligning the cost with users of the roads — visitors, deliveries, and commercial traffic. A PID can only be funded by property tax.
- A PID is controlled by the county commissioners. It can be voted in but not voted out. Even the reduction in the Burgundy Park mill levy is structured by the county as a “temporary credit.”
- The elected town council decides what portion of voter-approved road bonds are actually issued. If $15 million is approved but a smaller amount is more prudent, the council can issue less.
- Some HOAs with private roads collect adequate assessments for proper repairs and routine maintenance. Others (notably two condo complexes) do not budget for road capital projects and may eventually need a special assessment. HOAs will have the option, but not the requirement, to dedicate their roads to the town — transferring responsibility for repairs, maintenance, and snow removal.
Are We a Community or Not?
When Boulder County stepped away from responsibility for Niwot’s roads decades ago, the decision’s meaning was simple:
It became Niwot’s problem.
It’s easy to think about roads as “my road” — the stretch in front of your house. But that’s not how roads actually work.
There is no “my road.”
There is only a community network of roads.
The 50 feet in front of your home doesn’t get you anywhere. What matters is the entire system — the roads to downtown, to school, to your neighbors, out of town and back. Much of that system isn’t in front of anyone’s house. Who maintains the roads around Niwot Elementary? Who pays for the miles that don’t front private property? Who pays for roads that serve multiple neighborhoods?
Those are community roads, and they require a community solution. No outside agency is coming to fix this.
This is Niwot’s responsibility — and it requires a Niwot solution.
Incorporation isn’t about creating a problem. It’s about taking control of one we already have — and solving it before it becomes much more expensive.
Choosing not to incorporate is often described as doing nothing, or as keeping the status quo. In practice, it is an active decision to pay far more later for the same problem. These roads will be repaired. The only questions are when, and at what cost.
Deferred for nearly thirty years.
Each year of delay makes repair more expensive.
The habit of neglect embeds.
- Roads with PCI > 50 can be crack-filled and slurry sealed for about $0.68/sf.
- Roads where the PCI falls below 50 need mill & overlay at about $3/sf.
- Roads where the PCI falls below 25 need full-depth reconstruction at about $6/sf.
Roads degrade every year. Bad roads degrade even faster. The community is already paying a cost in lower property values.
The three available paths differ on more than dollars. They differ on who decides. A PID is controlled by Boulder County commissioners — voted in but not voted out. A town council is your neighbors — accountable to you, replaceable by your vote. Same roads. Different answer to the question of whose voice carries.
Your money. Your roads. Your priorities.
Decided by neighbors you can vote out — not by commissioners you can’t.
What Are the Options?
Three mechanisms are technically available to address Niwot’s roads. They differ substantially in cost, control, and coverage.
| Town Recommended path |
Community-wide PID | Neighborhood PIDs |
|---|---|---|
| What’s the same | ||
| Similar general pavement-management plan | ||
| Financed by 20-year bond assumed @ 4.62% (Feb 2026 rates + 50 bps)* | ||
| What’s different | ||
| Funded primarily by sales tax, partially paid by non-Niwot residents | Funded only by property tax of at least 14 mills (if attempted again) | Funded only by property tax of at least 20–25 mills |
| FDR for PCI < 25; M&O for PCI 25–50; chip seal for PCI 50–70 | R&R for PCI < 50 (cost model; could use FDR); M&O for PCI 50–70 | R&R for PCI < 50 (cost model; could use FDR); M&O for PCI 50–70 |
| Actual bids @ $6.08/sf for FDR with all uplifts (~$1M/mile) | County cost of $10–11/sf (~$1.75M/mile) per County Public Works in 2025 | County cost of $10–11/sf (~$1.75M/mile) per County Public Works in 2025 |
| Town administration, local control | County administration | County administration |
| Automatic traffic-control devices on residential streets with good sightlines; 3.5% of base cost. See MUTCD — FHWA. | CDOT-1 traffic control | 15% of base cost, per Springhill proposal in 2022 |
| Once decades of neglect are remedied, transition to a less expensive pavement-management plan | Mill levy can be voted in but not voted out. Only the county can reduce it. | Mill levy can be voted in but not voted out. Only the county can reduce it. |
| Annual cost in 2030 = $1.8M | Annual cost in 2030 = $2.3M | Depends on neighborhood — see examples below |
| Total allocation to roads in 2030 = $2.5M | Total allocation to roads in 2030 = $2.3M | — |
*Bond financing scenarios provided in February 2026 by Piper Sandler (Piper Sandler Public Finance). Piper Sandler issued the $19.2 million in wastewater revenue bonds in 2024 for the Niwot Sanitation District (transaction detail).
Examples of Taxes by Home Value
The dollar scale varies by chart. Town bars stack property tax (4 mills) and sales tax (2.5%); PID bars show property tax only.
Estimated sales-tax revenue (not counting downtown shops and restaurants) is $1.375 million per year. The single-resident chart assumes one resident; the others assume the Niwot average of 2.7 residents per home.
Property tax is straightforward to calculate. Residents can estimate the town’s proposed sales tax using the tax calculator on niwot.town or by multiplying approximate household purchases by 2.5%.
Questions & Answers
Aren’t our roads basically fine? Can’t we just slurry or chip seal everything?
Road condition is not subjective. The Pavement Condition Index (PCI) of the county-owned roads was measured in 2025 by IMS Infrastructure Management Services (ICC-IMS) at the request of Boulder County Public Works. The county map below shows the result: blue is good, yellow is fair, red is poor. Private HOA roads are not color-coded.
The list below shows the roads the county has repaired since 2015, as provided by Dan DeLange, Boulder County Public Works, in August 2025. Rows in green remain on the county’s repair list; rows in red have been dropped. Some downtown roads (1st, 3rd, 4th, 5th) and Gold Nugget (a special project to fix a water line under the road) are still “blue,” but they are not on the county’s repair list and will eventually degrade with no owner.
| Road | Approx. Year | Treatment |
|---|---|---|
| 79th | 2022 | Overlay |
| Monarch | 2022 | Overlay |
| Niwot | 2019 | Overlay |
| 2nd | 2023 | Overlay |
| 83rd | 2017 | Reconstruct |
| Neva | 2019 | Reconstruct |
| Longview | 2015 | Overlay |
| Somerset | — | Chip |
| 95th | 2020 | Overlay |
| Morton | 2020 | Overlay |
| Walker | 2020 | Overlay |
| Paiute | 2020 | Overlay |
| Marathon | 2020 | Overlay |
| Burgundy | 2020 | Reconstruct (PID) |
Green = remains on county repair list. Red = removed from list.
Niwot’s 31.4 miles of road break down as follows. Nearly three-quarters has no funded repair plan.

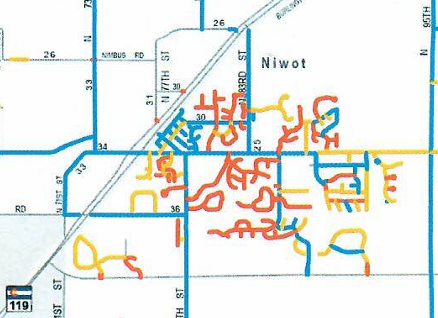

The 23 miles in the “No One Repairs” category average a PCI of 44. As the comparison table below shows, that is well below every comparable Colorado municipality — including towns smaller than Niwot. Chip and slurry sealing can extend the life of roads with PCI > 50, but they do nothing for roads below 50. Roads with PCI < 25 need to be reconstructed; PCI 25–50 needs mill and overlay. (Boulder County’s PID cost model assumes all roads with PCI < 50 need full reconstruction, which raises the initial project cost.) Burgundy Park’s PCI was approximately 44 prior to its PID reconstruction; the only other PID neighborhood, Homestead, has a PCI between 15 and 24.
| City / Town | Approx. Population | Avg. PCI |
|---|---|---|
| Golden | 20,000 | 84 |
| Lakewood | 156,000 | 83 |
| Denver | 710,000 | 80 |
| Erie | 30,000 | 78 |
| Broomfield | 75,000 | 75 |
| Fort Collins | 170,000 | 74 |
| Loveland | 80,000 | 74 |
| Thornton | 145,000 | 73 |
| Longmont | 100,000 | 71 |
| Firestone | 15,000 | 71 |
| Louisville | 21,000 | 67 |
| Durango | 20,000 | 67 |
| Wheat Ridge | 32,000 | 66 |
| Littleton | 46,000 | 63 |
| Pueblo | 112,000 | 62 |
| Niwot | 4,306 | 44 |
The distribution of Niwot’s road miles by PCI bucket makes the problem visible. A typical Colorado town — Firestone, for example — has most of its road miles clustered in the 60–90 range with very little under 50. Niwot has roughly a third of its mileage below PCI 30 and only a small fraction above PCI 80.
The road repair and maintenance costs in the pro forma budget seem too low to be believable.
The costs are based on industry standards and actual bids from qualified contractors. In addition to the basic per-square-foot repair cost, typical and expected “burdens” or “uplifts” for a construction project of this size and scope are included.
The pro forma budget includes three separate road-related line items:
- An initial major road repair project to bring all public roads in Niwot up to good condition (PCI > 70). Total cost in 2026 of ~$11 million, assumed to inflate to ~$12 million by 2029 plus the cost of any further degradation. The project is funded by a voter-approved road bond of up to $15 million in 2029. Annual repayment cost in the first full year (2030) = $1.235 million assuming the full $15 million is issued.
- Annual maintenance cost of ~$0.4 million for pothole and crack sealing on 20% of total roads (29 miles, including main arteries) at $13K/mi, plus chip or slurry sealing 15% of total roads at $82K/mi. The figure is derived from a database of every road’s square footage, including cul-de-sacs. Another $100K is budgeted for materials related to neglected infrastructure (roads, sidewalks).
- Snow removal, signs, lights, and related road operations of ~$0.15 million. Modeled separately in the pro forma to reflect different cost drivers and seasonal variability.
- Contribution to reserves of ~$0.65 million. Roads are by far the largest town asset, and these reserves are expected to be used for future major road repair projects. Proper ongoing maintenance (item 2) will extend the life of many roads for decades, especially those without through-traffic or heavy equipment use; some residential collectors will need to be overlayed after roughly 20 years.
The total annual road allocation is ~$1.8 million/year in operating costs (bond repayment plus maintenance plus snow/signs), with an additional ~$0.65 million contributed to reserves — for a total of approximately $2.5 million committed to roads in 2030. The charts below show the broad revenue and expense categories in 2030.
Contractors that provided estimates

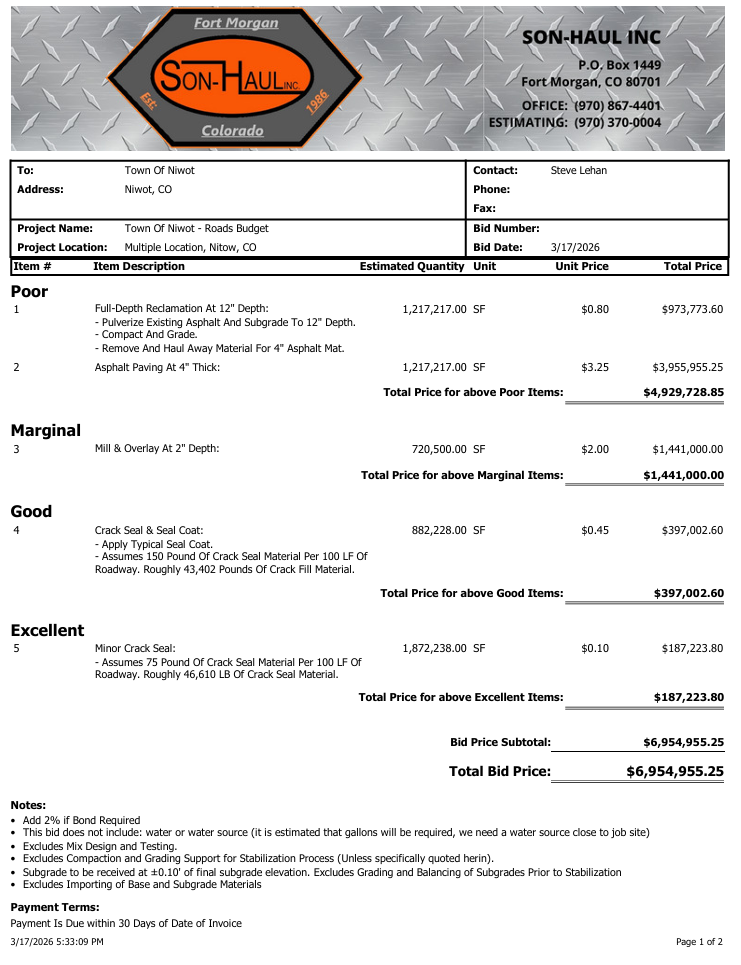

- Son-Haul, Inc., Fort Morgan CO — most recent bid; see appendix.
- Enright Asphalt, Denver CO
- Blacktop Plus, Denver CO
The 2025 community-wide PID worked off a $53M estimate for road rehabilitation over 25 years. How does that reconcile with the incorporation estimates?
Any PID would be governed by Boulder County and must use the County’s cost numbers, which are intentionally conservative so that the PID fully covers unexpected costs. The two costs that matter most are the initial project cost and the annual tax. Per the Boulder County Subdivision Paving PID page, the pavement-management plan is essentially the same as the town plan, except that when setting the mill levy the County assumes the most expensive reconstruction method — remove and replace (R&R) at PCI < 50. The PID can later accept a bid using Full Depth Reclamation (FDR), but higher costs are assumed up front.
- Reconstruction (initial project cost)
- Mill and overlay approximately every 20 years
- Chip seal work approximately every 7 years
Unlike the town pro forma — which separates road bond repayment and annual maintenance — all of the costs in a PID are covered by a single property-tax mill levy. The mill levy must cover the cost of financing as well as construction, since the county will no longer provide funds to a PID.
Because state law limits a PID bond term to 20 years (the same term assumed for the incorporation road bond), the right comparison is 20 years, not 25.
PID model
- 2025 PID expected revenue at 12 mills = $2.26 million/yr, of which 95% ($2.15 million) would go to roads (the other 5% to the Niwot Master Plan).
- Initial project cost in 2025: ~$25 million.
- Estimated cost inflated to 2029 at 3%: ~$28 million (potentially higher with continued degradation).
- Total financing cost for a 20-year bond of $28 million at 4.62%: ~$19.5 million.
- Total revenue required over 20 years: $47.5 million for roads.
- Annual cost for a $28 million project: $2.3 million.
Why was the PID talking about 25 years instead of 20? The mill levy required for the usual 20-year cycle of county major-road repairs worked out to over 14 mills. To lower the cost to 12 mills, the PID used a 25-year assumption.
Town model
The town model is an initial project cost in 2026 of $11 million, inflated to $12 million in 2029. The $15 million road bond in the pro forma is conservative. It results in an annual cost of $1.235 million for the bond plus ~$0.4 million for routine maintenance and ~$0.15 million for snow removal and related road operations, totaling approximately $1.8 million/year. With the ~$0.65 million reserve contribution, approximately $2.5 million is allocated, if needed, for roads.
How long will it take to actually fix the roads? Will it become a fight between neighborhoods over which roads get done first?
Because the Town Model uses Full Depth Reclamation (FDR), the time required to complete the entire initial project is measured in months, not years.
Assuming voters approve the road bond on the November 2026 ballot:
- August 2027
- Town officials are installed.
- During 2028
- Road project is engineered, logistics are planned, bids are solicited, the total amount of road bonds to issue is decided (not necessarily the full $15 million), bond issue is prepared.
- April 2029
- Road bonds issued based on sales tax revenue in 2028.
- Summer 2029
- Project begins.
- End of 2029 to Early 2030
- Project completed.
Planning the project in 2028 means it is ready to go as soon as the funds are available in 2029, avoiding competition over which roads get done first. Every road gets repaired in the same program.
Timing matters. The longer the community waits, the higher the cost — and not only because of inflation. Road condition declines faster after PCI drops below 60. Waiting until PCI drops below 50 quadruples the cost by moving from slurry seal ($0.68/sf) to M&O ($3/sf). Waiting until PCI drops below 25 doubles the cost again by moving to FDR ($6/sf).
Why can’t individual neighborhoods just fix their own roads?
Niwot has 18 HOAs and 10 non-HOA neighborhoods with failing roads owned by Boulder County. (This does not include the 10 HOAs with private roads that were never accepted for maintenance by the county.) Two ideas come up for how these 28 neighborhoods could “fix their own roads”: (1) have the HOA do it, or (2) a neighborhood PID.
Have the HOA do it — but HOAs aren’t allowed to
A common misconception is that HOAs can fix county-owned roads. There appears to be a loophole in county regulations that might allow an HOA to repair the roads, but discussions with the county show that any HOA doing so would take on full liability for the roads in perpetuity, and would risk the county objecting to the outcome. County paperwork and conversations with the Transportation Department confirmed this. The engineer explained that the county could declare the work was not up to county standards and require the HOA to redo it. Liability for any accident attributable to road condition would also fall on the HOA.
Second, the Colorado Common Interest Ownership Act (CCIOA, Title 38 C.R.S.) limits the use of HOA funds to common elements. A road dedicated to the county is not a common element, so the HOA cannot be the funding mechanism. A pre-1992 HOA not subject to every part of CCIOA might be able to work around this, but only if its Declaration of Covenants permits assessments to be spent on public property.
A neighborhood PID — small-scale, expensive
A local PID is the only available option for a neighborhood that wants to go it alone. Boulder County has set up the mechanism and will help with the process — details are on the Subdivision Paving PID page. Burgundy Park took this path in 2017. It is the only successfully established PID referenced on the county website, although the county notes that “several other subdivisions are currently working towards forming their own PIDs.” Homestead in Gunbarrel began the process in 2022, formed the PID in 2024, and received bids in 2026. For both neighborhoods, the county offered to pay 30% of the initial project cost and fund the work with an interest-free loan.
The county no longer offers to pay any part of the initial project work and will only help secure funding via loan, bond, or similar instrument. Interest costs are then paid by the PID, adding roughly 70% to the property tax required. The alternative is for the PID to collect funds until enough cash is on hand to start the work — delaying repairs by 8–10 years (and increasing the cost in the meantime).
Forming a neighborhood PID is not impossible, but it requires substantial effort and a dedicated group of volunteers. The county chart below shows the steps involved; the time from initiation to road work is often measured in years. Costs for smaller-scale projects are high. Burgundy Park’s initial mill levy was 16.597 mills; after the work was completed and property valuations rose, the commissioners agreed to temporarily reduce the levy to 12.25 mills. Homestead’s mill levy is 23.61 mills. Springhill HOA investigated the option in 2023 and estimated at least 23 mills based on county cost estimates and the requirement to cover financing. Any new neighborhood PID should expect at least 20 mills, more likely 25.
A separate problem with neighborhood PIDs is the question of who fixes roads that serve more than one neighborhood — Meadowdale Dr, Dry Creek Rd, Longview Dr, Somerset Dr. The closest neighborhood? The one with the most houses? Even if several subdivisions go the PID route, it does not solve Niwot’s community-roads problem.
| Step | Due Date | Task | Responsible Party |
|---|---|---|---|
| 1 | February | Subdivision provides letter to Public Works expressing interest in forming a PID | Owners/HOA |
| 2 | — | Identify proponents (minimum recommended: three) | Owners/HOA |
| 3 | — | Identify proposed district boundary | Owners/HOA |
| 4 | — | Identify proposed district improvements/projects | Owners/HOA |
| 5 | — | Estimate costs (either annual or whole project) | Public Works (PW) |
| 6 | — | Estimate mill levy based on district boundary and assessed values | PW and GIS Staff |
| 7 | March | Develop petition with information from steps 2 to 6 | PW and County Attorney |
| 8 | — | Verify petition meets minimum statutory requirements | County Attorney’s Office |
| 9 | — | Collect signatures | PID Proponents |
| 10 | Early June | Submit petitions | PID Proponents |
| 11 | July | Schedule BOCC hearing (20–40 days after submission) | County Staff |
| 12 | — | Clerk publishes notice and sends to all electors and municipalities within 3 miles | Clerk |
| 13 | — | Board adopts resolution establishing the District | BOCC |
| 14 | August | Certify ballot language | County Clerk and Recorder |
| 15 | November | Hold election | County Clerk and Recorder |
| If the election is successful | |||
| 16 | Dec/Jan | Develop and sign intergovernmental agreement with Boulder County (if necessary) | PID and BOCC |
| 17 | Feb/Mar | Develop project scope, plan specifications, and estimates | Public Works |
| 18 | Apr/May | Secure funding via loan, bond, or other instrument (if necessary) | PID (County) Finance Staff |
Individual PIDs sound like a lot of work at high mill levies. What about a revised version of the community-wide PID that was withdrawn in 2025?
The 2025 PID proposal was researched with Boulder County and qualified for the November 2025 ballot through the work of a dedicated group of volunteers. Once on the ballot, the proposal drew opposition from several places — most notably HOAs with private roads, residents on roads the county has maintained at least somewhat in recent years, and Burgundy Park residents who already have a PID. Based on the input, surveys, and objection letters from attorneys, the organizers withdrew the petition. Home Rule incorporation emerged as a more comprehensive solution at an overall lower cost for roads. The PID volunteers are now part of the incorporation effort.
Another PID excluding certain properties could be possible, but it would not be a complete community solution. Excluding properties raises the tax rate on the remaining owners, which makes passage harder. The diagrams below contrast the 2025 community-wide proposal with a possible alternative that excludes private and PID properties; all figures are in 2025 dollars.
Red areas are included in the PID property tax; green areas are excluded. Essentially all of the road work is for the 73% of roads in the “No One Repairs” category, so the construction cost is the same in either scenario.
Don’t residents on private roads, county-maintained roads, and in Burgundy Park have a point? Why should they have to pay for a community-wide solution — Town or PID?
Roads are a community asset that a properly functioning municipality pays for. Because Boulder County abandoned most of the roads and refused to accept maintenance responsibility for others, neighborhoods and HOAs have reasonably had to act in their own interest. The roads still have to be paid for one way or another, but the considerations differ by neighborhood type.
Private roads — good condition
Ten HOAs own the roads in their subdivisions. For most of these HOAs, the roads appear to be in relatively good condition, though PCI ratings are not available and recent work may have been limited to slurry coating. The HOA collects assessments for repairs, maintenance, and snow removal. If these HOAs choose, the roads can be dedicated to the Town of Niwot by mutual agreement, transferring responsibility for repairs, maintenance, and snow removal to the town. The roads would come off the HOA reserve study liability, and assessments could be reduced accordingly.
Private roads — fair condition
Countryside and Cottonwood Condominiums HOAs share Countryside Dr, and Countryside HOA is responsible for Countryside Park and Countryside Lane. Countryside HOA’s 2021 reserve study by Aspen Reserve Specialties (ASR) indicates that crack fill and pothole maintenance should be an annual operating expense, that asphalt should be seal-coated every 3–4 years, and that the roads will need mill & overlay in approximately 2037. ASR estimated an M&O cost of $1.65–$1.90/sf in 2021, which inflates to roughly $2/sf plus overhead today — consistent with current estimates.
The reserve study combines roads and parking lots. The roads alone total about 72,000 sf between the two HOAs. At an expected cost of $3/sf with overhead, an M&O project runs ~$216,000 across 260 units, or about $830/unit. According to the property manager, road projects are funded as needed with minor repairs and seal coating; no funds are being set aside for the eventual M&O project.
The HOA financials include annual snow removal expenses, presumably for both roads and parking lots. Some property owners argue that since their HOA doesn’t collect dedicated road assessments, there would be no “savings” in transferring roads to the town. That view overlooks the eventual $830/unit M&O liability and the ongoing snow-removal cost. Roads are paid for one way or the other, and the cost doubles if the HOA waits until the roads need full reconstruction.
The town’s proposed 4 mills property tax on an average-value condominium in these HOAs is about $90/yr. The proposed sales tax (assuming $12,800 in purchases per person and single occupancy) is about $320/yr. At least some of this is offset if the HOAs dedicate their roads to the town.
County-maintained roads
Some properties are on roads that the county has repaired in the past 10 years (Somerset, parts of Longview, Morton, Walker, Paiute, Marathon). Others are on roads worked on more than 10 years ago but still in good shape (Murray, 1st, 3rd, 4th, 5th, Gold Nugget). These roads will need annual maintenance and future repairs that the county may no longer provide. A few residential properties and many commercial properties are on roads that will be part of an intergovernmental agreement between the county and the town — streets in many Boulder County municipalities that pass through the municipality are still maintained by the county.
Burgundy Park PID
Burgundy Park passed a PID in 2017 at 16.597 mills. The county paid 30% of the initial project cost and funded the road reconstruction with an interest-free loan repaid from the PID. For taxes paid in 2025, the county commissioners stated:
The county loan will be fully repaid in 2026 or 2027. Upon incorporation, and assuming the debt is fully repaid (by the PID or the town), management of the PID transfers to the town council.
By mutual agreement of the potential Town Council and the Burgundy Park property owners, the PID could be dissolved and all road repair costs transferred to the town, removing the current 12.250 mill levy for these owners.
Some in Burgundy Park have suggested the town should reimburse them for PID taxes already paid. Those funds have been spent. The only mechanism in Colorado law for reduced property-tax areas within a municipality applies to economically distressed areas. The town council and Burgundy Park owners could consider creative options, such as keeping the PID in place at a very low tax rate so it receives special treatment on future road projects.
I’m opposed to any new taxes. As long as I can drive on the roads, I’d rather do nothing — it doesn’t really affect me.
Some costs hold a community together, and community roads are one of them. If you never plan to sell, lower taxes may beat higher property value — a reasonable preference. For most owners, though, your home is the largest asset you’ll eventually sell, and road condition affects what it sells for.
Key considerations
The absence of a funding source for road repair can be a material adverse fact when selling a home. A seller’s failure to disclose a known adverse material fact affecting the property can create legal liability. Homes adjacent to county roads must disclose this on the Colorado Seller’s Property Disclosure form. Road disrepair (especially if it impacts access) and the absence of any maintenance or repair plan would typically qualify for disclosure in the “Other Known Adverse Material Facts” section — the section that requires disclosure of any known adverse fact affecting the property even if it’s not specifically listed. If a seller has specific knowledge (for example, the county’s 2025 notices that no repairs are planned without a PID) that a reasonable buyer wouldn’t discover through ordinary inspection, it must be disclosed. Visible potholes are usually considered “patent” (obvious), but the absence of a repair plan is not obvious and can be material.
Poor roads cause vehicle wear and increase accident risk — both direct costs you pay.
Road condition matters to property values. Roads in disrepair raise annual vehicle operating costs — the ASCE Infrastructure Report Card estimates over $1,400 per driver per year. Deteriorated roads are also linked to elevated accident risk and slower emergency response, both of which influence buyer perception. Empirical studies consistently show a positive correlation between road quality and home prices: homes on streets rated “good” command higher prices than those on streets rated “poor.” Visible infrastructure decay signals public neglect and discourages new residents and investment.
Deferred maintenance also compounds. As roads deteriorate, the investment required to restore them grows non-linearly. Homebuyers price that risk in, which leads to lower offers and slower sales cycles in areas with visibly poor roads.
References
- ASCE Infrastructure Report Card — Roads (poor roads cost U.S. drivers ~$1,400/year)
- Pew Charitable Trusts — State Road Funding Gaps (2025)
- Rural Economic Impact — Road Deterioration and Property Values
What is FDR? Is it an acceptable way to fix our roads? I’ve heard the incorporation plan is a “cheap” way of fixing the roads.
FDR is full-depth reclamation. Instead of digging out and hauling away failed road base, the existing pavement and base are ground up in place and mixed with concrete and other additives to create a uniform subbase. FDR is increasingly used in Colorado for both municipal streets and state highways. It recycles existing asphalt and base layers into a strong foundation for new pavement, significantly reducing material transport and disposal costs. Cities and towns across Colorado — from Meeker to Denver and Centennial (work done by Son-Haul, who has provided Niwot’s attached bid) — use this method for road reconstruction projects. FDR has also been used in Longmont, Fort Collins, Weld County, Greeley, Breckenridge, Fort Morgan, and by CDOT (CO Hwy 13 south of Meeker).
Case studies report 35–40% cost savings and substantial CO2 emissions reductions compared to traditional remove-and-replace (R&R). FDR also reduces sensitivity to oil-price volatility.
See the May 5, 2025 article by Scott Sounart, PE (Broomfield, Colorado): Full-Depth Reclamation: Sustainable Asset Management (Kimley-Horn).
Advantages over traditional methods
Structural restoration. Unlike overlays that mask surface-level issues, FDR addresses deep structural failures (base degradation, alligator cracking) by rebuilding from the pavement foundation up.
Cost efficiency. FDR reduces material hauling, eliminates import/export of aggregate, and uses equipment efficiently. Lifecycle costs are generally lower than full R&R when full-depth problems exist.
Time savings. FDR compresses construction time; projects that take weeks with R&R are often completed in days, reducing traffic-control costs and disruption.
Sustainability. Nearly 100% of the material is reused in place, minimizing landfill use, hauling emissions, and carbon footprint.
For roads with structurally sound bases, overlays suffice at lower cost than FDR. The town model uses FDR for roads with PCI < 25, M&O for PCI 25–50, crack sealing and seal coat for PCI 50–70, and minor crack sealing for PCI > 70.
Consensus from current literature
Sources highlight FDR as best practice for reconstructing roads with failed structural layers. The National Cooperative Highway Research Program (NCHRP) synthesizes DOT practices showing FDR adoption as standard for in-place recycling when the subgrade is stable but asphalt and base layers have failed. Modern engineering standards prioritize FDR for cost, time, and environmental efficiency. FDR is widely regarded as a current leader in sustainable, cost-effective, and rapid road rehabilitation for pavements with deep distress.
If the incorporation vote fails, what happens to the roads?
The roads still need repair. That doesn’t change. What changes is whether there is a community-wide solution on the table.
The volunteers who built the 2025 community-wide PID proposal are now part of the incorporation effort. The county’s public position has not moved: 23 miles will not be repaired by Boulder County. There is no other coordinated, community-wide effort underway.
Three consequences follow:
- Neighborhood-by-neighborhood becomes the only path. A patchwork of individual PIDs at 20–25+ mills, each requiring its own volunteer organizers, signature drive, county process, and election. Only two neighborhood PIDs have ever completed the process in unincorporated Boulder County — Burgundy Park (2017) and Homestead (2024).
- Shared roads have no owner. The residential collectors that serve multiple neighborhoods — Meadowdale Dr, Dry Creek Rd, Longview Dr, Somerset Dr — aren’t fixed by anyone’s neighborhood PID. They keep degrading.
- The cost rises every year. Roads below PCI 50 need mill & overlay ($3/sf); below PCI 25 they need full reconstruction ($6/sf). Whatever the eventual repair cost is, it is lowest today.
A “no” vote is not a vote for the status quo. The status quo is already eroding. It is a vote to handle the roads neighborhood-by-neighborhood, at higher cost, on a longer timeline, with no owner for the roads that connect us.
Roads Are One Part of a Bigger Decision
Roads are the most visible problem, but they are not the only one. For roughly the same cost as fixing roads alone, incorporation also gives Niwot control of its own land use, protection from county wage policy, and a seat at the regional table on every decision that affects the community — from Xcel franchise terms to bike-path alignments to how state housing requirements land near the CO 119 transit corridor.
The 2025 community-wide PID solved one problem at 12 mills of property tax. Incorporation solves the same problem at a comparable total cost — 4 mills of property tax plus a 2.5% sales tax that visitors and commercial traffic also help pay — and addresses every other structural gap left by being unincorporated.
Same cost as roads alone.
Same roads — and a voice in everything else.
Take the next step
See your actual cost · Read the FAQ · Talk to a neighbor · Sign the petition
Appendix — Son-Haul Base Bid
Below is the most recent contractor bid received from Son-Haul, Inc. (Fort Morgan, CO), with adjustments and uplifts applied to produce the project total.
| Line Item | Description | Amount | Notes |
|---|---|---|---|
| Son-Haul Base Bid | All pavement treatments (FDR on poor roads, mill & overlay, seal coats, crack sealing) | $6,954,955 | Bid total as submitted |
| Performance / Payment Bond | 2% of base bid (required on most public projects) | $139,099 | Explicitly noted in Son-Haul bid; standard for municipal work |
| Mobilization | Contractor setup, demobilization, equipment transport | $347,748 | 5% of base (typical range 4–8% for mid-size paving jobs in CO) |
| Traffic Control | Flagging, signs, barricades, management during work | $243,423 | 3.5% of base (CDOT pay estimates show $1,000–$1,400/day; multi-road project) |
| Erosion Control / SWMP | Silt fence, seeding, stormwater management plan | $69,550 | 1% of base (required by CDPHE/CDOT for any earth disturbance) |
| Mix Design & Testing | Lab mix design, compaction testing, material verification (especially FDR) | $175,000 | Excluded in bid; typical $100K–$250K for FDR + asphalt stabilization at this scale |
| Water Source & Usage | Water for FDR mixing/compaction (noted as excluded) | $75,000 | Excluded in bid; FDR can require tens of thousands of gallons |
| Subgrade Grading, Compaction Support & Material Import | Balancing subgrade, additional base import if needed | $450,000 | Exclusion in notes; ~9% on the $4.93M Poor category only |
| Construction Subtotal | Direct contractor work + above adders | $8,454,775 | ~21.5% markup on base bid |
| Engineering / Design / Bid Solicitation | Plans, specs, bidding, permitting | $550,000 | ~8% of construction subtotal (standard municipal soft-cost range) |
| Project Supervision / Inspections / CM | Resident engineer, daily inspection, quality control | $450,000 | ~6.5% of construction subtotal |
| Contingency | Unforeseen conditions, price escalation, change orders | $950,000 | 10% of construction subtotal (typical for multi-site road program) |
| Soft-Cost Subtotal | All non-construction items | $1,950,000 | — |
| PROJECT TOTAL | Full estimated delivered cost | ≈ $10.4 million | Range: $9.8M–$11.0M depending on actual testing/grading needs |
Key footnotes & assumptions
- All percentages are derived from 2024–2025 CDOT cost data books, Colorado municipal paving bids, and FDR guidelines (e.g., Asphalt Recycling & Reclaiming Association).
- Soft costs (15–20% total) are typical for Colorado town/county road programs of this size.
- No curb projects are included. Niwot is almost entirely curbless. Unless structural curb damage occurs, no curb projects are necessary for paving.
